Cape Town Plumbing Certificate: What Property Sellers Need to Know in 2026

Updated 2026 · 7-minute read · Western Cape CoC Certificate

Get a Free Plumbing CoC Quote — Fast

Tell us what you need and we’ll send your price now.

📋 Please complete every field, including your full address — accurate details mean an accurate quote.

Prefer to talk? Call 076 157 8456

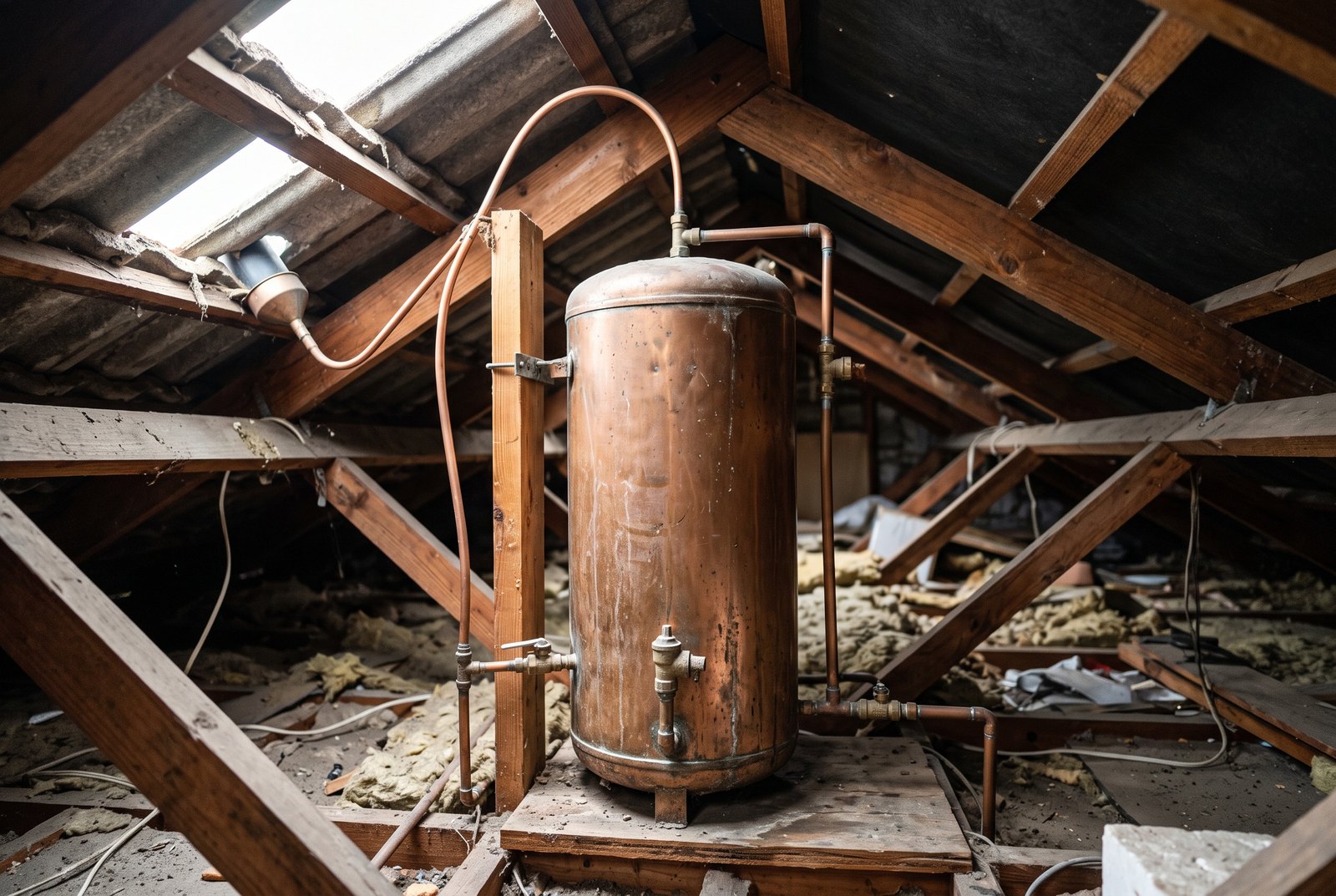

Geyser and overflow pipework inspected for a plumbing Certificate of Compliance
Plumbing CoC points sellers are caught by.
In short: Selling a property inside the City of Cape Town means the law requires a plumbing Certificate of Compliance — the Schedule 4 water-installation certificate — completed by a City-registered plumber and submitted to the City by your conveyancer before the transfer can be registered.

Western Cape CoC Certificate has been issuing plumbing compliance certificates in Cape Town for over 25 years, with more than 10,000 plumbing inspections completed across the City Bowl, Southern Suburbs, Northern Suburbs, and surrounding areas. The Plumbing CoC is perhaps the least understood compliance certificate in Cape Town property transactions — many sellers, and even some estate agents and conveyancers from other provinces, are unaware it exists. This guide covers everything sellers need to know in 2026.

Cape Town-specific requirement: The Plumbing CoC is mandatory under the City of Cape Town Water Services By-law No. 14 of 2010 (as amended). This by-law applies within the City of Cape Town municipal boundary only — if you are selling in Stellenbosch, Drakenstein, or Overstrand municipality, a plumbing CoC is not required (though it may be requested by banks).

The Schedule 4 Certificate — Cape Town’s Official Plumbing CoC Form

Conveyancers and banks often call the plumbing CoC the Schedule 4 certificate. The name comes from the City of Cape Town Water By-law: Schedule 4 of the by-law prescribes the exact form of the Certificate of Compliance of Water Installation, and the document you receive after a passed inspection is that prescribed form.

Only a plumber registered with the City of Cape Town may complete and sign the Schedule 4 form. PIRB or IOPSA membership alone is not enough — the plumber must appear on the City’s own register of accredited plumbers.

The signed certificate goes to the City before transfer. In practice your conveyancing attorney submits it to the Water and Sanitation Department, and the transfer cannot be registered until the City has received it. The official Schedule 4 form download (PDF) and submission instructions are on the City of Cape Town website.

Where the Plumbing CoC Fits in Your Transfer Timeline

  1. Sale agreement signed. The standard Cape Town sale agreement makes the seller responsible for compliance certificates. The seller pays for the plumbing CoC unless the contract says otherwise.
  2. Book inspections early. Book the plumbing inspection together with the electrical CoC as soon as the agreement is signed — waiting for bond approval wastes 2–4 weeks of the transfer clock.
  3. Remediation and certificate issue. Around 41% of Cape Town homes need some remedial work first. Once the installation passes, the Schedule 4 certificate is issued.
  4. Conveyancer submits to the City. Your attorney sends the certificate to the City of Cape Town before lodgement in the Deeds Office. Registration of transfer cannot proceed without it.

Cost responsibility for each certificate type is covered in who pays for a CoC when selling, and the paperwork sellers should line up is in the property transfer CoC checklist.

What Does the Cape Town Plumbing CoC Inspection Cover When You Sell?

A plumber registered with the City of Cape Town tests the following elements of your property’s water installation:

Water Supply System

  • Water meter condition and legibility
  • Main stop valve operation
  • Internal supply pipe condition and pressure
  • Pipe sizing per SANS 10252-1
  • Backflow prevention devices
  • No cross-connections between potable and non-potable water

Drainage System

  • Correct fall on drainage pipes (minimum 1:60 for horizontal runs)
  • No blockages or displaced joints
  • Correct ventilation (P-trap/bottle trap condition)
  • No drainage to stormwater
  • Manhole access and condition

Geyser & Hot Water

  • Pressure/temperature relief valve (P&T valve) correct type and condition
  • Drip tray condition and discharge pipe
  • Drain cock on cold water inlet
  • Correct pipe sizing on hot water outlets
  • No active leaks at connections

Fixtures & Fittings

  • No active leaks at taps, showers, or toilets
  • Toilet cistern condition (no continuous running)
  • Correct toilet connection to drainage
  • Basin, bath, and shower trap condition
  • No unlicensed secondary water connections

How Much Does a Plumbing CoC Cost the Seller in Cape Town?

Property Type Bathrooms Inspection Cost Avg Remediation
Small flat / studio 1 R1,100–R1,400 R0–R2,500
2-bedroom flat / townhouse 1–2 R1,400–R1,800 R0–R4,000
3-bedroom freehold home 2 R1,700–R2,100 R0–R6,000
4-bedroom+ home / double storey 3+ R2,100–R2,500 R0–R9,000

Plumbing Defects That Delay Cape Town Property Transfers

Approximately 41% of Cape Town homes require some plumbing remediation before passing their first inspection. The most frequent defects we find:

  1. Defective or absent P&T relief valve on geyser — occurs in 28% of inspections. The P&T valve must open at 700 kPa and 90°C and must be the correct type for the geyser brand and pressure rating. Replacement cost: R350–R800.
  2. Active pipe leaks — 22% of inspections. Often from older copper compression fittings or plastic push-fit joints. Repair cost: R600–R2,500 depending on location and pipe material.
  3. Incorrect geyser drip tray or discharge pipe — 19% of inspections. The drip tray must discharge to a visible point outside the ceiling space, not to the ceiling void. Cost to rectify: R350–R800.
  4. Continuously running toilet cistern — 16% of inspections. Ball valve or flap valve replacement: R250–R600 per toilet.
  5. No backflow prevention device — 14% of inspections. Required where the supply connects to any appliance or system that could contaminate the potable water supply. Cost: R400–R900.
  6. Unlicensed borehole or greywater connection — 8% of inspections. The City of Cape Town requires specific licensing and separation for any secondary water source. Rectification can be complex and costly — R3,000–R12,000.

Seller’s Pre-Inspection Checklist — Plumbing CoC

Run through this plumbing CoC checklist before the inspector arrives. Ten minutes of preparation prevents the most common re-inspection call-outs.

  • Clear access to the geyser — the ceiling hatch must open and the inspector must reach the geyser, drip tray and valves.
  • Fix running toilet cisterns — a continuously running cistern is a listed defect found in 16% of inspections.
  • Check for visible leaks at taps, under basins and around toilet bases — even a slow drip is recorded.
  • Locate the water meter and main stop valve, and check the meter glass is legible.
  • Disclose any borehole, wellpoint, rain tank or greywater system up front — unlicensed connections are the most expensive surprise.
  • Have previous compliance certificates ready — they help the inspector trace earlier remedial work.
  • Book the electrical CoC for the same visit — one access window, one trip fee saved.
  • Allow 60–90 minutes for a standard home, and make sure someone can let the inspector in.

Frequently Asked Questions — Selling With a Plumbing CoC in Cape Town

Can I sell my house in Cape Town without a plumbing certificate?
No. Inside the City of Cape Town municipal boundary the Water By-law makes the plumbing CoC compulsory for every property transfer. Your conveyancer must submit the certificate to the City before the transfer is registered, so the sale cannot conclude without it.
What is a Schedule 4 certificate?
The Schedule 4 certificate is the official name for Cape Town’s plumbing CoC. Schedule 4 of the City of Cape Town Water By-law prescribes the form of the Certificate of Compliance of Water Installation, which is why conveyancers and banks refer to the plumbing certificate by its schedule number.
Who pays for the plumbing CoC — the seller or the buyer?
The seller. The City of Cape Town Water Services By-law places the obligation on the seller of the property, and standard Cape Town sale agreements assign compliance certificates to the seller. A buyer only pays where the sale agreement expressly shifts the cost.
How long is a plumbing CoC valid?
A Cape Town plumbing CoC is transaction-based. It certifies the water installation for the current transfer of ownership, and a new certificate is required at each subsequent transfer. It does not carry a multi-year validity the way an electrical CoC (2 years) or gas CoC (5 years) does.
What happens if the plumbing inspection finds defects?
The inspector issues a defect list instead of the certificate. Once a plumber completes the repairs, a re-inspection confirms compliance and the Schedule 4 certificate is issued. Around 41% of Cape Town homes need some remedial work before passing, and most defect lists are resolved within 2–5 days.
My property is in Bellville / Tygervalley / Brackenfell. Do I still need a plumbing CoC?
Yes. Bellville, Tygervalley, Brackenfell, Parow, Goodwood, Milnerton, Tableview, and Blouberg are all within the City of Cape Town municipal boundary and are subject to By-law No. 14 of 2010. The plumbing CoC requirement applies. Areas outside the City of Cape Town municipality (Stellenbosch, Franschhoek, Drakenstein/Paarl, Overstrand/Hermanus, George) are NOT subject to this by-law and do not require a plumbing CoC for property sales.
How long does a plumbing CoC inspection take?
For a standard 3-bedroom home: 60–90 minutes. For a large property with multiple bathrooms and geysers: 90–150 minutes. When conducted simultaneously with an Electrical CoC, both can be completed in a single 2–3 hour window. Plumbing inspections require all taps and water points to be accessible and for the inspector to open the ceiling access hatch to inspect the geyser installation. Ensure this is cleared and accessible on inspection day.
Does my property need a plumbing CoC if it is on a borehole?
Yes, if it is connected to the municipal supply as well (the vast majority of Cape Town properties are). The inspection covers all City of Cape Town water supply connections and internal plumbing. For properties with an additional borehole or rainwater harvesting system, the inspector will verify that the secondary water source is correctly isolated from the municipal supply with an approved backflow prevention device and that the system is appropriately licensed by the City of Cape Town Water and Sanitation department. Unlicensed secondary water systems are the most expensive defect to remedy — budget R3,000–R12,000 for rectification.
